Status as of September 5, 2025
Building a Better Bal Harbour for You
Project Overview and Benefits
The Village is currently improving the underground utilities within the gated residential community. Street paving follows the underground work to restore roadways throughout the area. While design work for these phases began many years ago, Phase 3 and 4 constructions 305-993-7361arted in April of 2020, and in Phases 5 and 6 in 2022. We anticipate all phases of work to be completed by 2027.
While design work for these phases began many years ago, construction started in Phases 3 and 4 in April of 2020, and in Phases 5 and 6 in 2022. We anticipate all phases of work to be completed in 2027. Below is a brief synopsis of the work and schedule within each zone.
Once completed, these improvements will provide our residents and guests with:
- A safe and efficient water supply system
- A sanitary sewer system that meets regulatory requirements
- A system that reduces groundwater infiltration
- An enhanced stormwater system that more efficiently disperses stormwater after rain events
- A system that minimizes any pollutants from stormwater discharging into Biscayne Bay.
Below is a brief synopsis of the work and schedule within each zone.

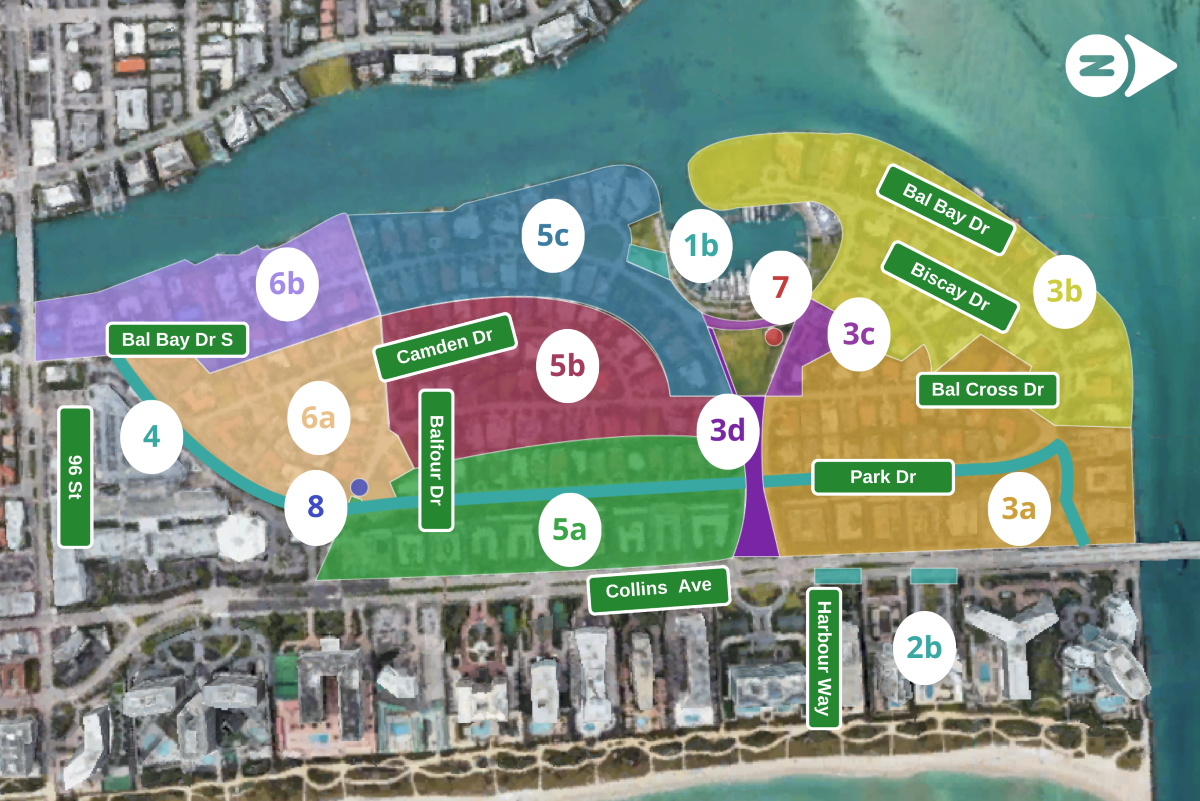

The overall neighborhood improvements have been broken into zones or phases. This helps focus on the contractor’s area of impact and completes larger sections of the neighborhood in a strategic way to minimize traffic and utility service disruptions throughout the neighborhood.
Completed Projects:
Phase 1B
Phase 2B
Phase 3A & 3B
Phase 4
Phase 5A
Under Construction and Future Work
Includes milling and paving along the roadway. Removal and replacement of damaged curb and gutter. Replacing the installing water mains, relocating water services from rear of homes to front of homes, and the repair and reconstruction of the Stormwater Pump Station on Harbour Way West.
Phase 3C
Milling and Paving Scheduled For Early 2027
Phase 5B & 5C
Stormwater Drainage Improvements
Phase 6A
Scheduled for October 2025
Phase 6B
Scheduled for November 2025
Phase 7
Reconstruction of the Stormwater Pump Station – Scheduled for October 2025
Future Project Phase
Phase 3D
Phase 8 – Proposed Drainage Improvement Project For The Area Of 6A Along The New Stormwater Pump Station Near The Intersection Of Park Drive And Bal Cross Drive. Pending Funding

What You Should Expect
- Routine project updates will be distributed to provide information on upcoming work and anticipated traffic impacts.
- Future paving operations will require coordination with each of the homes in that area as vehicle traffic will be limited throughout the work zones during the placement of asphalt. More information will come before the paving is scheduled.
Text & Email Updates
Text Notifications
Sign up to receive text message updates regarding this project by texting “BetterBH24” to “69310.”
Email Notifications
Sign up to receive regular email updates regarding the Utility Infrastructure Improvement Project and applicable road closures.
Who to Contact
For more information, please contact Public Works or 305.993.7361.
